Project Summary
The City of Minnetonka will complete sanitary sew improvements along Park Ridge Drive West and Live Oak Drive, west of Hopkins Crossroad. This project replaces a 53-year-old sewer force main from Sherwood Lift Station to the new force main that was installed at Live Oak Drive and Hopkins Crossroad in 2025.
Project schedule
Construction is scheduled to begin on or around Monday, Aug. 17 and will last approximately 8-10 weeks.
Detailed information regarding construction will be communicated on this project website and via email updates.
Traffic impacts

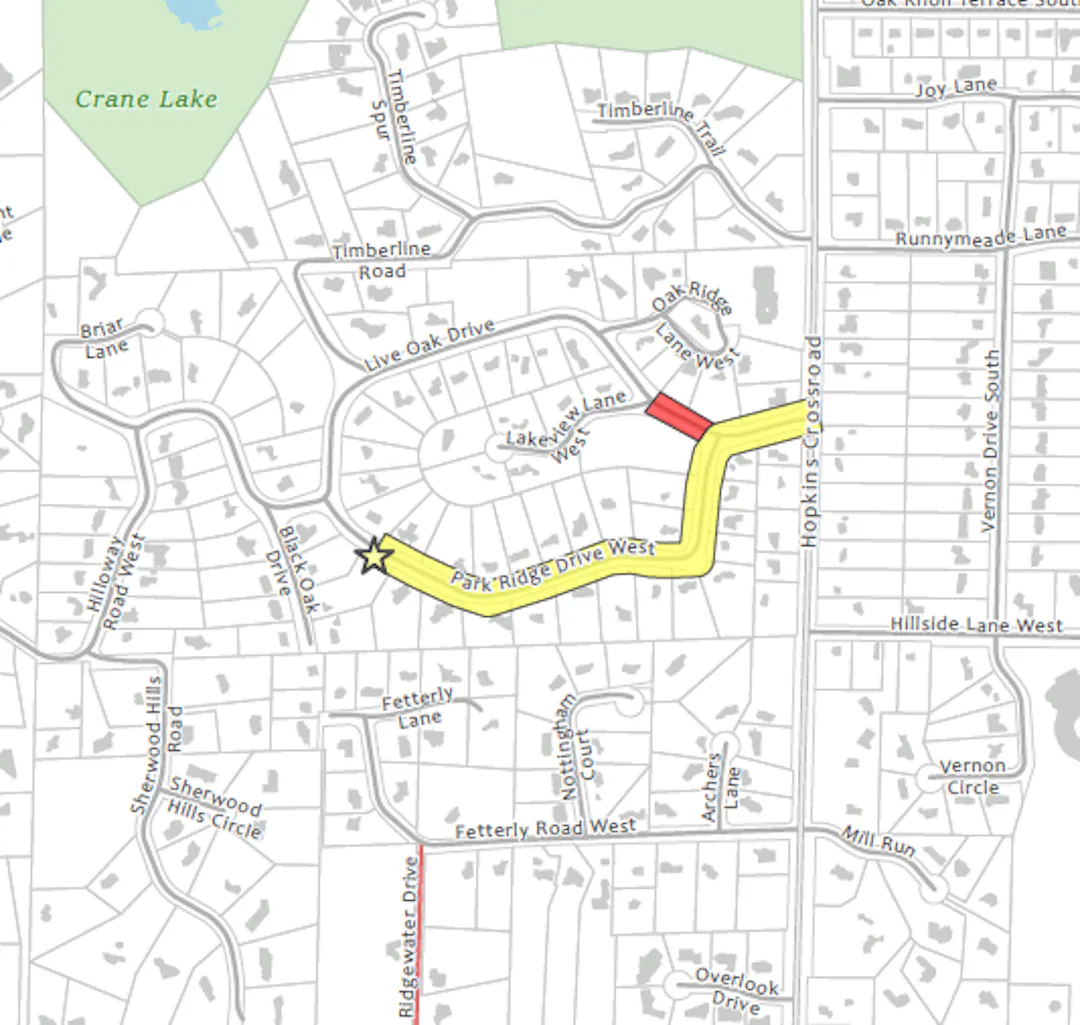

During construction, Live Oak Drive will be closed between Lakeview Lane West and Park Ridge Drive West to stage contractor equipment and materials.
Park Ridge Drive West and Live Oak Drive east of the closure will remain open to traffic. Access to driveways will be available, with the exception of short closures for pipe connections.
Follow construction signs and watch for traffic pattern changes. Drive carefully and expect delays.
Will I be assessed?
No. The City of Minnetonka does not assess for these improvements. The project is funded through the city's Utility Fund.
The City of Minnetonka will complete sanitary sew improvements along Park Ridge Drive West and Live Oak Drive, west of Hopkins Crossroad. This project replaces a 53-year-old sewer force main from Sherwood Lift Station to the new force main that was installed at Live Oak Drive and Hopkins Crossroad in 2025.
Project schedule
Construction is scheduled to begin on or around Monday, Aug. 17 and will last approximately 8-10 weeks.
Detailed information regarding construction will be communicated on this project website and via email updates.
Traffic impacts
During construction, Live Oak Drive will be closed between Lakeview Lane West and Park Ridge Drive West to stage contractor equipment and materials.
Park Ridge Drive West and Live Oak Drive east of the closure will remain open to traffic. Access to driveways will be available, with the exception of short closures for pipe connections.
Follow construction signs and watch for traffic pattern changes. Drive carefully and expect delays.
Will I be assessed?
No. The City of Minnetonka does not assess for these improvements. The project is funded through the city's Utility Fund.
Share Project substantially completed on FacebookShare Project substantially completed on X (formerly Twitter)Share Project substantially completed on LinkedinEmail Project substantially completed link
The Contractor has completed the bulk of the work and only small clean up items remain. Thank you for your patience.
The Contractor has completed the bulk of the work and only small clean up items remain. Thank you for your patience.
Share Curb and gutter replacement complete on FacebookShare Curb and gutter replacement complete on X (formerly Twitter)Share Curb and gutter replacement complete on LinkedinEmail Curb and gutter replacement complete link
Share Restoration begins next week on FacebookShare Restoration begins next week on X (formerly Twitter)Share Restoration begins next week on LinkedinEmail Restoration begins next week link
Share Force main lining complete; restoration begins on FacebookShare Force main lining complete; restoration begins on X (formerly Twitter)Share Force main lining complete; restoration begins on LinkedinEmail Force main lining complete; restoration begins link
Share Lining to continue through next week on FacebookShare Lining to continue through next week on X (formerly Twitter)Share Lining to continue through next week on LinkedinEmail Lining to continue through next week link
Share Cleaning and televising completed on FacebookShare Cleaning and televising completed on X (formerly Twitter)Share Cleaning and televising completed on LinkedinEmail Cleaning and televising completed link
This week’s progress included:
Pipe cleaning and televising completed
Force main lining began
Next week’s activities include:
Force main lining will continue for approximately one week
This week’s progress included:
Pipe cleaning and televising completed
Force main lining began
Next week’s activities include:
Force main lining will continue for approximately one week
Share Pipe cleaning and televising underway on FacebookShare Pipe cleaning and televising underway on X (formerly Twitter)Share Pipe cleaning and televising underway on LinkedinEmail Pipe cleaning and televising underway link
Share Force main pipe removals begin next week on FacebookShare Force main pipe removals begin next week on X (formerly Twitter)Share Force main pipe removals begin next week on LinkedinEmail Force main pipe removals begin next week link
This week’s progress included:
Temporary bypass connected
Excavation of pits complete
Next week’s activities include:
Force main pipe removals at pit locations will begin
Pipe cleaning will begin
Televising of pipe will begin
Please be aware of traffic control changes and watch for changing traffic patterns.
This week’s progress included:
Temporary bypass connected
Excavation of pits complete
Next week’s activities include:
Force main pipe removals at pit locations will begin
Pipe cleaning will begin
Televising of pipe will begin
Please be aware of traffic control changes and watch for changing traffic patterns.
Share Temporary bypass connections next week on FacebookShare Temporary bypass connections next week on X (formerly Twitter)Share Temporary bypass connections next week on LinkedinEmail Temporary bypass connections next week link
This week’s progress included:
The Live Oak Drive road closure and detour were installed
Temporary bypass was prepared
Utility locating began
Excavation for lining pits began
Hydrant installation
Next week’s activities include:
Connection of temporary bypass
Excavation for lining pits will continue
Please be aware of traffic control changes and watch for changing traffic patterns.
This week’s progress included:
The Live Oak Drive road closure and detour were installed
Temporary bypass was prepared
Utility locating began
Excavation for lining pits began
Hydrant installation
Next week’s activities include:
Connection of temporary bypass
Excavation for lining pits will continue
Please be aware of traffic control changes and watch for changing traffic patterns.
Share Phase two begins Aug. 17 on FacebookShare Phase two begins Aug. 17 on X (formerly Twitter)Share Phase two begins Aug. 17 on LinkedinEmail Phase two begins Aug. 17 link
Work will begin on phase two of the Sherwood Force Main Replacement project on Aug.17, 2026.

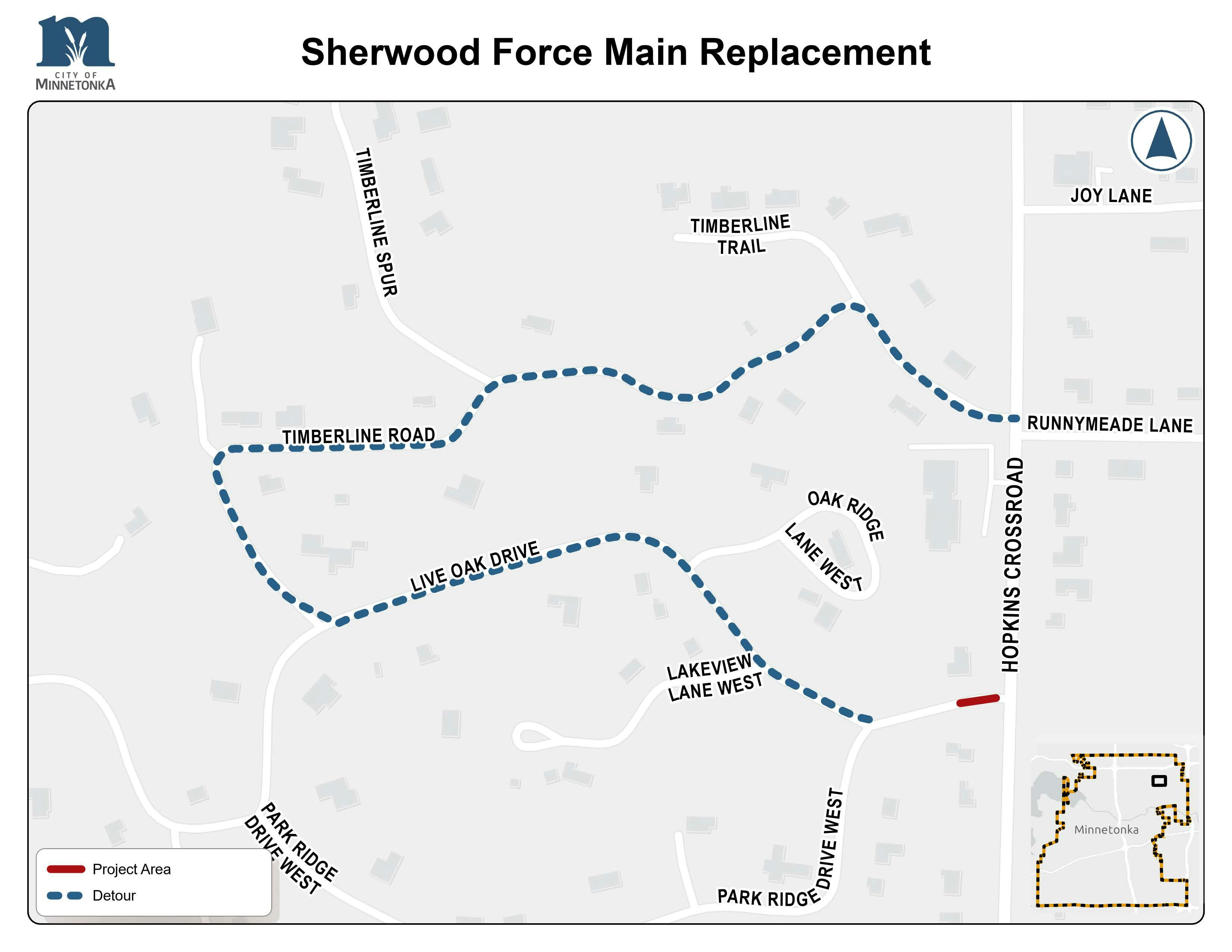

Live Oak Drive will be closed between Lakeview Lane West and Park Ridge Drive West to stage contractor equipment and operations. This closure will last the duration of the project.
Activities will include:
Traffic control setup
Sewer bypass installation
Excavation pits for lining
Please watch for traffic control changes and shifting traffic patterns.
Work will begin on phase two of the Sherwood Force Main Replacement project on Aug.17, 2026.
Live Oak Drive will be closed between Lakeview Lane West and Park Ridge Drive West to stage contractor equipment and operations. This closure will last the duration of the project.
Activities will include:
Traffic control setup
Sewer bypass installation
Excavation pits for lining
Please watch for traffic control changes and shifting traffic patterns.
